Nesting Planned Maintenance Routines
Nesting means linking two or more routines together so that the correct routine is raised into a work order. So it is applicable only when your asset is linked to two (more) routines.
The Problem
Say, you have a 1 month, a 3 month and a 12 month routine linked for a boiler. Before nesting, there will be two or three services due in some months. This means that you'll have two or three
work orders raised for the same job, which is unwanted because the 12-month
service contains the details of the 3-month service and the 3-month service
contains the details of the 1-month service.
The Solution
To overcome this problem, the best way is
to nest the 1-month service under the 3-month service, and nest the 3-month
service under the 12-month service. When they are both due, the system will
only raise one service into a work order.

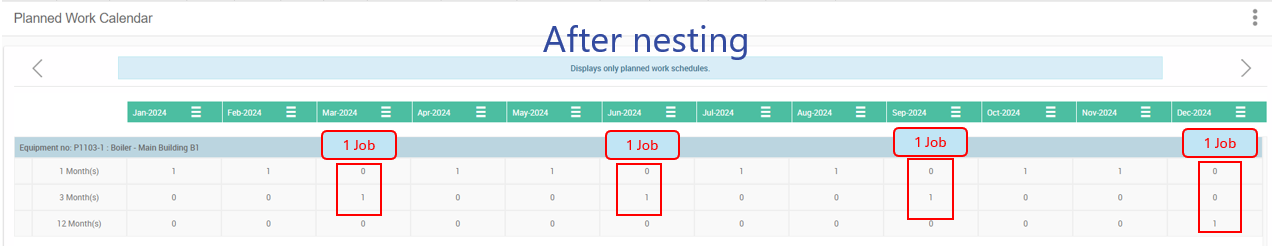

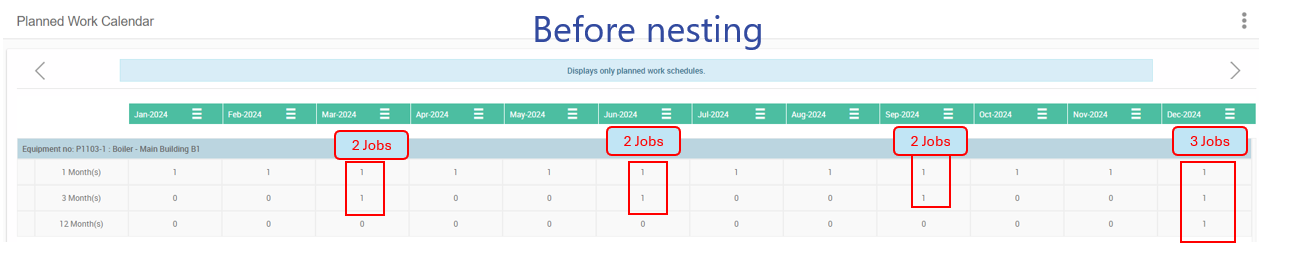

See the difference in schedules before and after nesting:
Notes
Please note that routines can be nested
only when they have the same frequency type, the same due date, the same skill,
and the Planned Work Type should match "Fixed."
Related Articles
Planned Maintenance - How to setup routines to an asset
Watch this video which will guide you in establishing and maintaining your Planned Maintenance schedule Preventative Maintenance is the key to long lasting and well-kept equipment. It minimizes the potential failures occurring during operation and ...
An Overview on How to Action Planned Work Orders
Preventative Maintenance is the key to long-lasting and well-kept equipment. Once set up with all the right information, the planned work module will automatically generate work orders to remind you when your Preventative Maintenance routines are due ...
Planned Maintenance Schedules: Predict when routines will be due
After the planned work setup, there are two areas in the system where you can predict when the routines will be due: Planned Work Calendar Report "Planned Work Schedules" They are very useful for the Chief Engineer or Maintenance Manager as they ...
How to Action Planned Work Orders from Planned Work Orders Page
This article is relevant for version 18 and above. An Overview of Planned Work Orders Page With the new planned work orders page, You can now efficiently manage all planned work orders from a single interface. It is an ideal place for the maintenance ...
How to reschedule a planned work order?
Unable to complete your planned Maintenance as planned? Watch this video: To learn how to reschedule your planned work. 1. Drag and drop the planned work order in the same month. On the Monthly View page, you can choose the planned work order, drag ...
